Construction of new Stage 2 Zone Substation around live infrastructure including buildings, structures and underground assets.
Click a marker to explore each work area

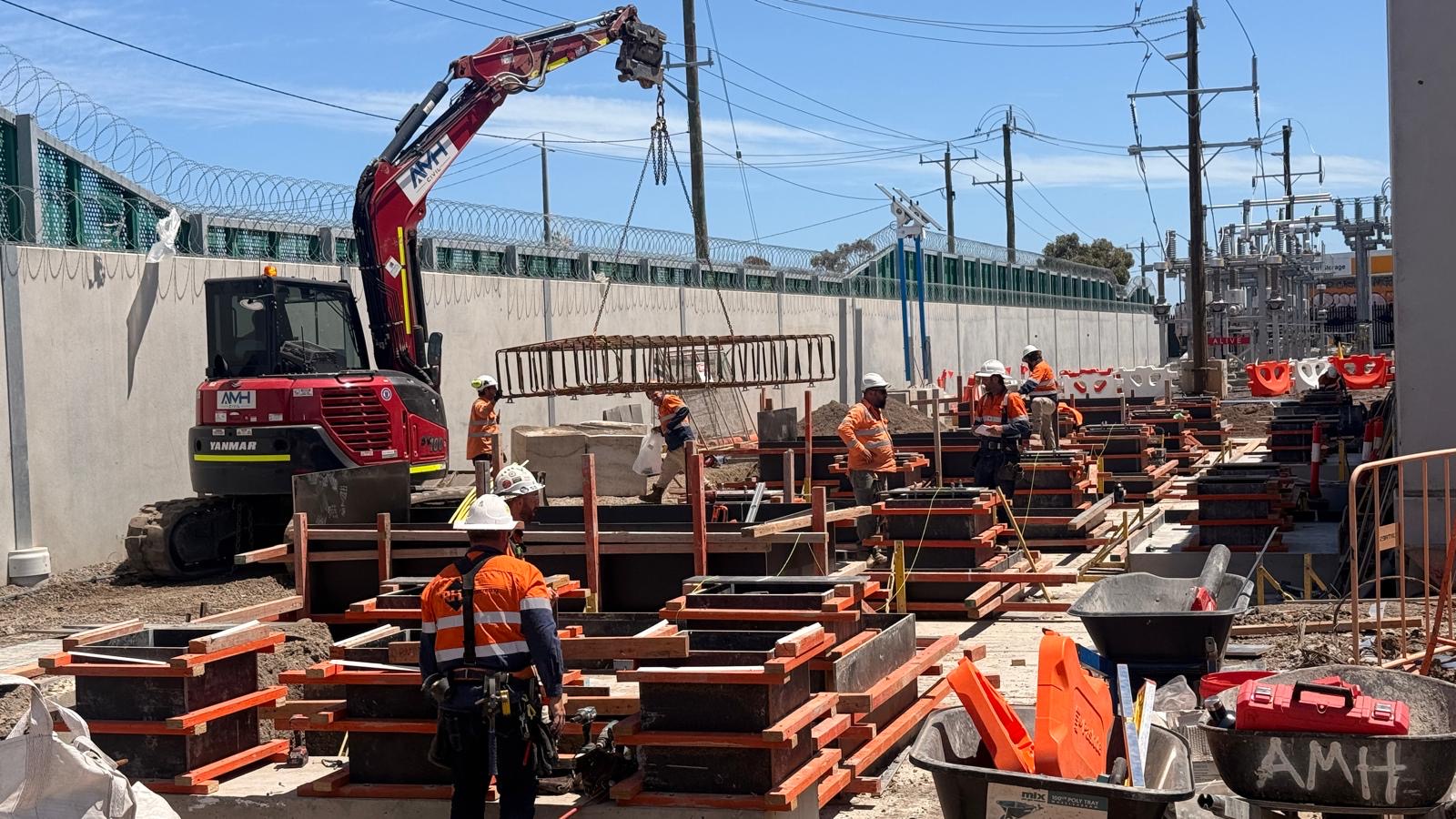

Transformer Bay Slabs & Switch Room Footings
Following building permit delays and some design changes, AMH Civil accelerated the construction of transformer bay slabs to ensure set-downs were complete ready for scheduled delivery.

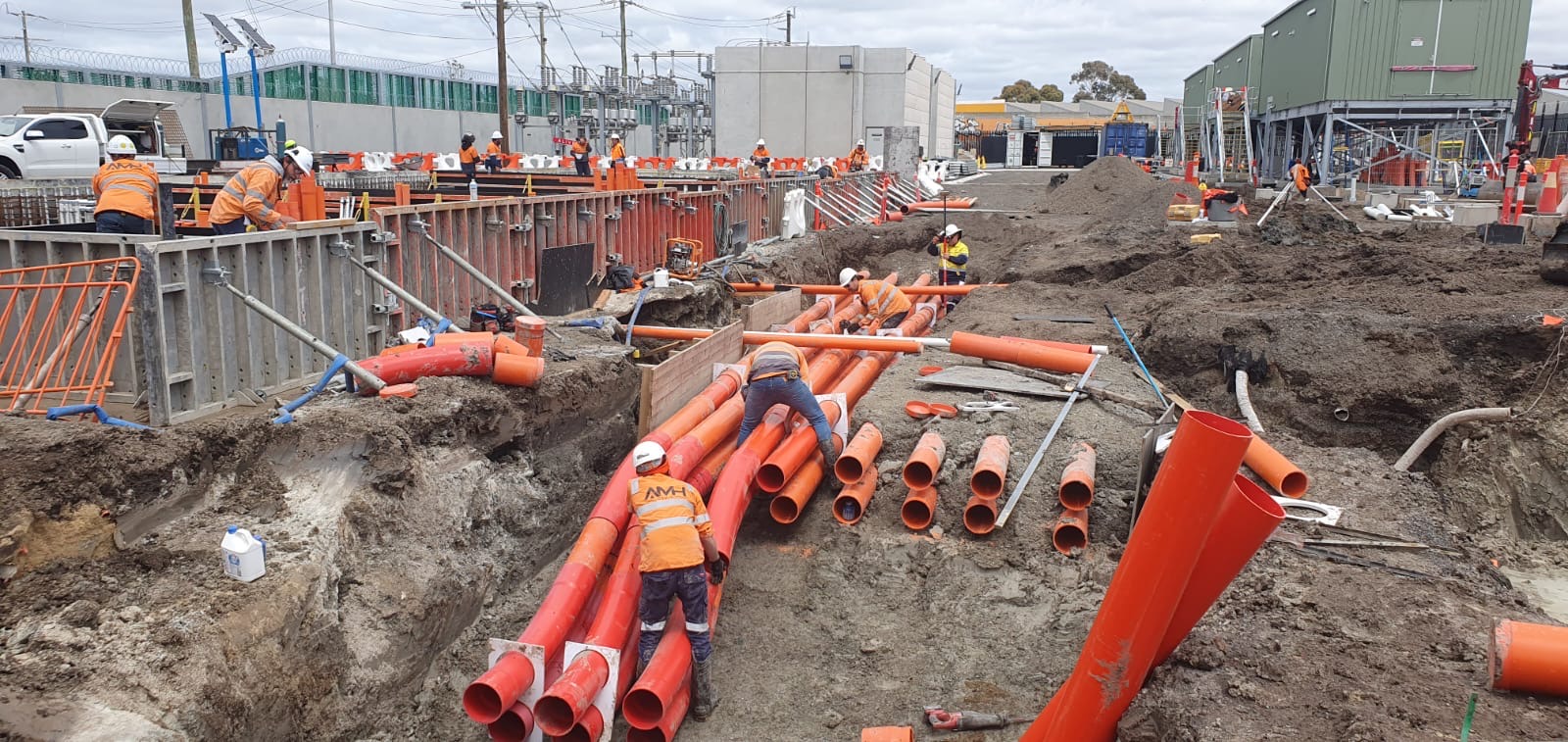

Complex Deep Conduits
AMH Civil modelled conduit runs and connections in 3D with sewer and stormwater, to perform clash detection and confirm bend radii and locations prior to construction. This allowed for safe installation concurrent with transformer bay footings and mitigated delays.

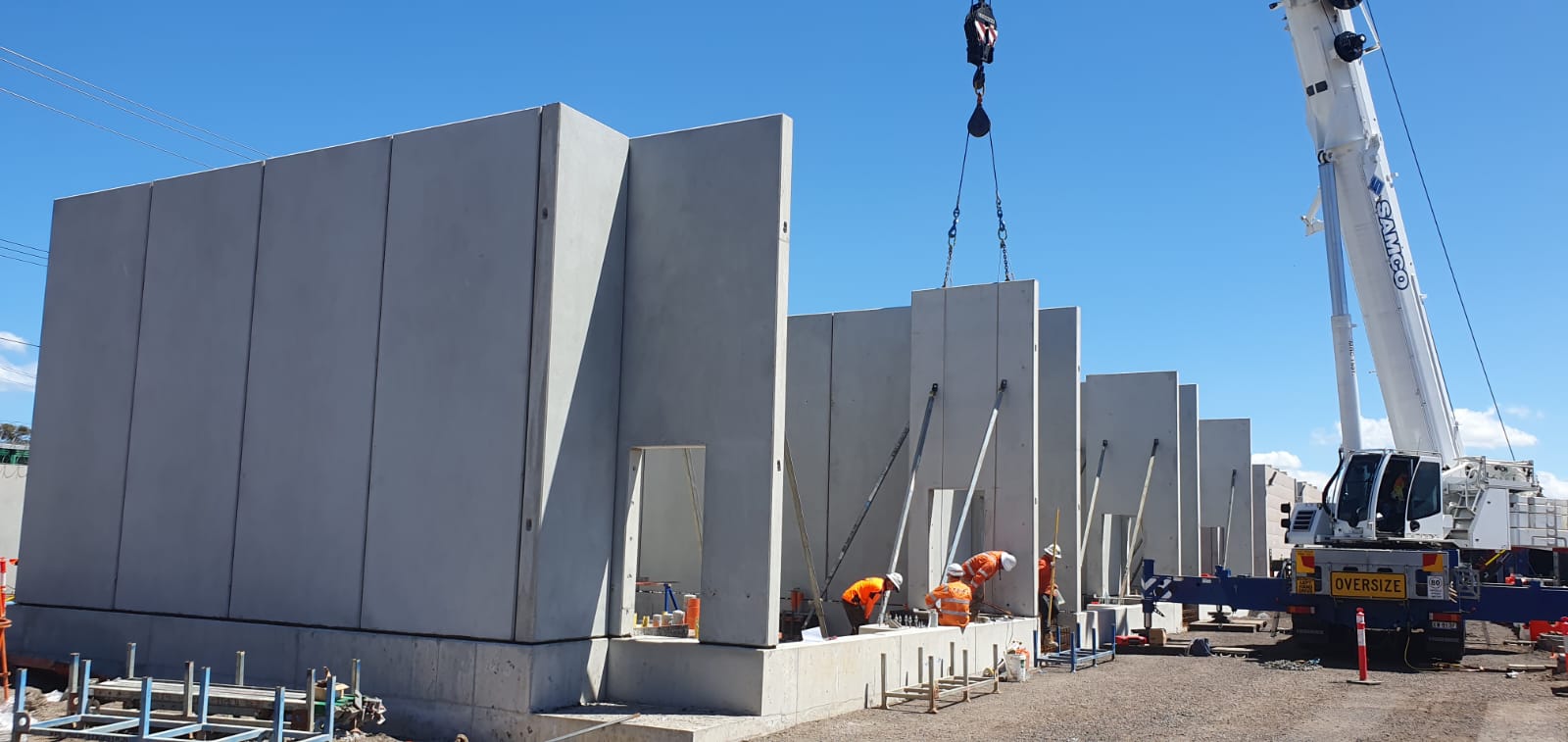

Tilt-Up Panels
AMH Civil reviewed shop drawings against design drawings, and worked with Samco Precast for the timely fabrication and seamless installation of transformer bay tilt-up panels on site.
